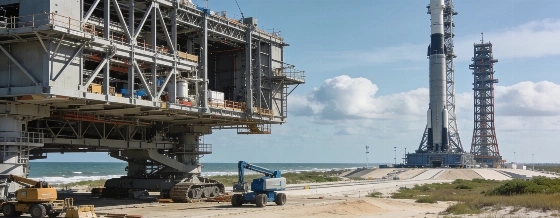

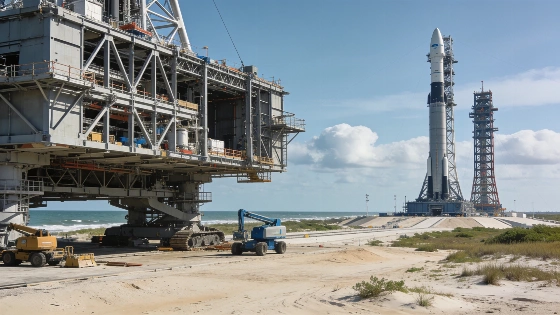

Blue Origin is rebuilding its Cape Canaveral launch complex after a New Glenn rocket explosion while constructing a second pad and new facilities to support the larger New Glenn 9x4 variant, which is still in development.
Blue Origin is expanding its launch infrastructure at Cape Canaveral Space Force Station as repairs continue after a destructive New Glenn rocket test in May 2026. The company is restoring Launch Complex 36A (LC-36A) while building a second pad, LC-36B, and support facilities for the larger New Glenn 9×4, a variant still under development. The parallel projects are meant to restore near-term launch capability while preparing the site for a more powerful vehicle and a higher launch cadence.
Infrastructure Recovery and Expansion
A New Glenn engine hot-fire, also known as a static-fire test, extensively damaged the existing LC-36 infrastructure in May 2026. Blue Origin continues repairs to LC-36A, which is expected to remain associated with the 7×2 configuration, as construction proceeds on LC-36B for the 9×4. Schedule projections have put restoration and renewed New Glenn operations in the fourth quarter of 2026, while separate reporting has moved the expected return toward early 2027. The estimates have shifted as recovery work continues. The expansion also includes a Vertical Integration Facility (VIF) and a Payload Processing Facility (PPF), designed to bring vehicle assembly and payload preparation closer to the launch site.
Blue Origin says the new pad will require up to 2,500 metric tons of steel, much of it for a planned 213-meter (700-foot) launch tower. LC-36B is also being designed for vertical integration to accommodate the greater height of future New Glenn vehicles. NASA schedule material reported in October placed readiness of a new pad by the end of the third quarter of 2027 and the first 9×4 flight in the fourth quarter of that year.
The planned 9×4 debut is linked to a second MK1 lunar mission and an uncrewed MK2 demonstration lander, tying the infrastructure build-out to Blue Origin’s lunar program and NASA’s Artemis-related planning. The company’s broader Florida expansion also includes plans to increase production at its Rocket Park campus near Kennedy Space Center, with capacity for as many as 150 New Glenn 9×4 upper stages annually by summer 2027. The reported investment in upper-stage manufacturing is approximately $330 million.
New Glenn Variants and Technical Details
The New Glenn family’s 7×2 and 9×4 designations refer to the number of BE-4 engines on the first stage and BE-3U engines on the upper stage. The 7×2 uses seven BE-4 engines and two BE-3Us; the developmental 9×4 is planned to use nine BE-4 engines and four BE-3Us. Blue Origin’s New Glenn vehicle overview describes the rocket program and its reusable first-stage design. The additional engines are intended to increase thrust and payload capability, supporting heavier commercial and government missions.
Both configurations are designed for reusability, with recoverable first stages. Reported projections put the 9×4’s potential payload capacity at up to 70 metric tons to low Earth orbit and up to 20 metric tons toward the Moon. These are planned capabilities, not demonstrated performance. The higher capacity is intended to broaden the range of missions New Glenn can serve, including future lunar flights.
Historical Context and Launch Cadence
Launch Complex 36 has a long history in American spaceflight, supporting Atlas-Centaur and Atlas I through III rockets from the 1960s until its decommissioning in the mid-2000s. Blue Origin took over the site in 2015 and began building its facilities the following year. The first New Glenn 7×2 launch from LC-36 took place in 2025, followed by two additional missions before the May 2026 incident. Before the explosion, Blue Origin had projected up to a dozen launches for 2026; the revised expectation is a single mission if repairs proceed as planned.
The fourth New Glenn rocket, designated NG-4, was destroyed during the May test, along with a payload of Amazon Leo satellites. In the aftermath, Blue Origin leadership outlined upgrades to the launch complex, including a new vertical operational concept for transporting rockets to the pad. The company is pursuing restoration alongside expansion, with LC-36A serving the 7×2 and LC-36B intended for the larger 9×4.
Blue Origin has also begun an environmental-review process to raise the proposed annual launch rate for the LC-36 complex from 12 to 50. The higher figure is a proposed operating capacity, not an approved launch rate: it depends on completion of the environmental review and the new infrastructure. Manufacturing capacity of up to 150 upper stages a year would exceed that launch target, leaving room for production and testing, as well as spare stages, as operations scale.
Implications for Commercial Launch
Blue Origin’s Cape Canaveral expansion comes amid increasing competition in the commercial launch sector. LC-36B and the New Glenn 9×4 are intended to position the company for heavier payloads and more frequent missions. The schedule will depend on repairs to LC-36A and completion of the new pad and integration facilities, alongside progress in 9×4 development and testing.
Launch-site recovery and infrastructure upgrades challenge other providers, too. Teams involved in NASA’s Juno mission to Jupiter relied on strong ground facilities and careful mission planning to support complex launches and spacecraft operations. The Atlas V rocket that launched Juno in 2011 was supported by extensive ground infrastructure, as described in this overview of Juno's mission architecture.
As Blue Origin works to bring both LC-36A and LC-36B online, its ability to meet its launch schedule will depend on the pace of repairs and integration of new systems, as well as successful development of the New Glenn 9×4. The outcome will affect commercial and national-security launches, along with the broader evolution of the U.S. launch industry.
Launch-pad construction involves more than assembling towers and integration facilities. It also requires fueling and safety systems, plus controls that must be tested and certified before a rocket can launch. Delays in any part of that process can affect mission schedules and the availability of launch services, showing the engineering and operational complexity of expanding access to space.
