A new AI data center campus in Ohio will use a dedicated 350-megawatt microgrid, operated by Veolia, to supply all its electricity needs. The project will bypass the regional grid and aims to accelerate the deployment of large-scale computing infrastructure.
A major AI data center campus under construction in Ohio will run entirely on a dedicated 350-megawatt (MW) microgrid, information from an announcement from Veolia, the French environmental services company selected to operate and maintain the system. Designed to function independently of the regional power grid, the system reflects a growing effort by AI infrastructure developers to secure electricity on site as demand for large-scale computing accelerates.

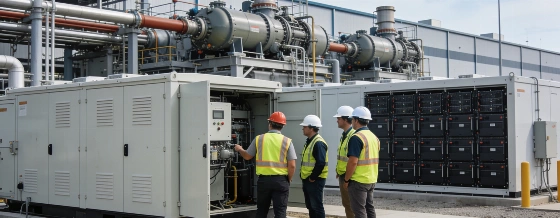

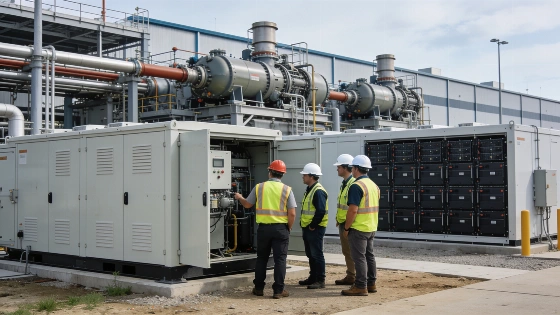

The microgrid will combine on-site gas engines and linear generators with a battery energy-storage system rated at 430 megawatt-hours (MWh). The 350 MW figure describes generation capacity, while 430 MWh measures the battery’s stored energy. Together, the equipment is intended to supply the campus’s AI workloads while reducing dependence on grid connections and limiting exposure to service interruptions. Veolia’s responsibilities include commissioning support, operating procedures and long-term maintenance under a performance-based contract.
The project comes amid wider delays in power-system development, but national interconnection statistics require careful interpretation. Lawrence Berkeley National Laboratory’s interconnection queue analysis found that, in regions with available duration data, projects reaching commercial operation in 2025 had a median wait of more than five years from their interconnection request. The finding concerns generation and storage projects seeking transmission interconnection, not data-center load requests, and does not establish a typical wait for every data center. At the end of 2025, roughly 2,061 GW of proposed generation and storage capacity was in interconnection queues. That total represents proposed projects, not capacity already built or available to serve customers.
Industry analysis has highlighted the mismatch between campus construction and grid schedules. EY’s engineering and construction practice summarized the risk this way: “Data centers can finish years before power arrives.” Behind-the-meter generation and storage can reduce reliance on conventional interconnection timelines, but they do not remove permitting requirements or obligations tied to fuel supply, air quality, water, noise and land use.
Veolia says the Ohio system is designed for 99.9% availability and will require an operating workforce of about 35 to 40 full-time employees. That target depends on coordinated operation and maintenance of the generation equipment and battery system. The company says its role includes preparing operating procedures and maintaining the assets under the performance-based agreement.
Ohio is also seeing other large, dedicated-power proposals for data centers. A separate gas-fired EdgeConneX proposal in Jersey Township, Licking County, has been associated with Ohio Power Siting Board case 26-0361-EL-BGN, with reported capacity estimates of about 430 MW to 450 MW. The proceeding illustrates that behind-the-meter projects can still face state siting review and public scrutiny. Another distinct proposal, an SB Energy campus at the former Portsmouth Gaseous Diffusion Plant, has been described as having potential data-center capacity of up to 10 GW, with OpenAI reportedly positioned to use as much as 8 GW. Neither project is the 350-MW Veolia microgrid.
Private energy infrastructure is becoming more common as developers seek to address grid bottlenecks and provide reliable power for high-density computing. In a related development, OpenAI recently announced plans for a $30 billion hyperscale data center campus in Georgia, aiming to deliver up to 3.2 gigawatts of computing capacity for advanced AI model development and deployment over the next decade.
Although designed to operate independently, the Ohio microgrid remains subject to the technical and regulatory challenges facing large private energy systems. These include maintaining a continuous fuel supply, managing battery performance and meeting safety and environmental standards. Long-term reliability will depend on maintenance, workforce training and the system’s ability to respond to changing energy and computing demands.
Microgrids are localized energy systems that can operate independently of the basic power grid. They can pair generation sources, including gas engines and linear generators, with batteries and automated controls. For AI data centers, they offer a way to tailor electricity supply to high-density computing and reduce reliance on grid interconnection schedules. Performance depends on strong engineering, continuous monitoring and the ability to respond to equipment failures or sudden changes in demand. As AI infrastructure expands, these systems are likely to face greater technical and regulatory scrutiny.
